Why Use This Procedure?
The purpose of the Check Delivery Times (CDT) is to create more reasonable Master plans. Manufacturing orders will be created with more reasonable finish dates, considering available capacity and material.
The CDT can be used to check when you can deliver a part on a customer order row.
It is also possible to check the finish period for a manufacturing order. The CDT indirectly describes when the manufacturing can be started for the order, which will make it a type of simulation to plan the start of a manufacturing order according to the available capacity.
Besides the fact that you directly check the order's delivery date or finish date, you can also make a simulation that will give a delivery notice without having an order. This is used to support the work of giving a delivery notice to the customer and, at the same time, make reservations to secure that delivery notice.
When running the CDT, a simulation takes place that calculates the delivery period for a certain part quantity or the finish period for a part on the manufacturing order. To check the possibility of manufacturing these parts during shortage, you can choose to explode the incorporated S-parts.
The CDT is a simulation based on the part quantity and the entered delivery period. The current loading situation and the available material will together form the basis for the calculation of a reasonable delivery date. The available capacity check searches for the first available capacity for each operation. The first start day to check available capacity is the following day. When using CDT, the current day (today) is not considered as an available day. The available material check uses the lead time to calculate the first available material to cover the shortage. The CDT result uses the least advantageous material or capacity value to report the best possible finish period for a new manufacturing order. In other words, the result of the best possible finish period can be both earlier and later than the requested.
After the simulation, it is possible to update the delivery period for a customer order or the finish period for a manufacturing order, if you have made the CDT from any of these procedures.
The CDT is more an "actual" simulation than the one in the Requirement Simulation procedure. The CDT creates reservations shown as default in the loading plan and requirements planning. Therefore, it is important that the CDT is based on actual orders or inquiries from customers. You should also purge "unnecessary" simulations from the system. When you close the window, a question will appear asking if you want to delete the simulations; read more under Valid through. In the Part Info, Requirement Calculation, Run Netting and Loading Plan procedures, you will see the reservations as default. But it is reported as a unique transaction type and can therefore be deselected.

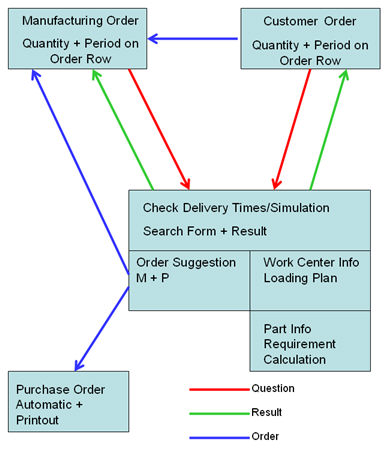

In the CDT you can take actions that may be required to deliver an order row. The actions in question are to create manufacturing and purchase orders from the order suggestions, that may have been created during the simulation (see image).
You can divide the use of the CDT into three different cases:
Configurations in the CDT
If you have installed the supplement Product Configurator and you load a configurable part (part linked to a configuration group) to a part row, the configuration window opens automatically. You can then use this window to configure the product on the part row. Please read more about the configuration window under the chapter Product Configurator in the Using MONITOR Procedures guide.
You can also load the configuration window manually on a part row by using the button under the Conf. column.
Window Functions
When you open the CDT from the menu, you select Run to start a complete simulation.
After the run is completed you use the same button, now called Re-do with New period, to recalculate according to the new suggested period.
Read more about the other Window functions under Window Functions in the MONITOR Basics guide.
